Expected Date of Completion : 31st December, 2008


Building Status as on 06-05-2008

Click here to view the pictures of Model Flat

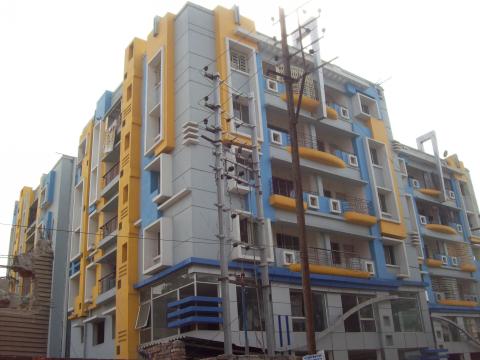

Block A
Foundation : Completed.

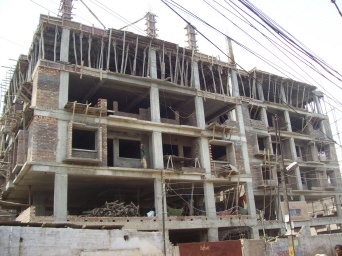

Casting : Salballa shouring - Completed, Basement - Completed, Retention wall - Completed, Ramp casting - Completed, Deck slab Completed, Ground floor roof slab - Completed, 1st floor roof casting - Completed. 2nd Floor roof casting - Completed. 3rd Floor roof casting - completed. 4th floor roof casting completed, 5th Floor column casting completed. 5th floor roof slab shuttering work completed, rod binding continuing.
Brickwork & Plaster : 1st & 2nd floor completed and 3rd floor continuing.
Elevation : 1st, 2nd and 3rd floor continuing.
Plumbing : 1st & 2nd floor completed (kitchen & toilet) 3rd floor continuing (kitchen & toilet) and water proofing - 1st & 2nd floor (Toilet area) completed.
Electricals : Conduit Pipe dressing & box fixing- 2nd floor completed and 3rd floor continuing.

more photos


Block B
Foundation : Completed.
Casting : Salballa shouring - Completed, Basement - 100%Completed with water proofing & plastering of Retention wall - Completed, Ramp casting - Completed, Deck slab casting Completed, Ground floor roof slab - Completed, 1st floor roof casting - Completed. 2nd Floor roof casting - Completed. 3rd Floor roof casting - completed. 4th floor roof casting completed, 5th Floor column casting completed. 5th floor roof slab work completed. Model Flat-Completed (Flat 1F)
Brickwork & Plaster : 1st, 2nd, 3rd & 4th floor completed & 5th floor continuing of brick work. Plaster- 1st, 2nd 3rd floor completed & 4th floor continuing.
Elevation : 1st, 2nd, 3rd, 4th & 5th floor continuing.
Plumbing : 1st & 2nd floor completed (kitchen & toilet) 3rd floor continuing (kitchen & toilet) and water proofing - 1st & 2nd floor (Toilet area) completed. 3rd floor continuing.
Electricals : Conduit Pipe dressing & box fixing- 2nd floor completed and 3rd floor continuing.
